15 Old Bailey, City of London EC4M 7EF

Hyde London City (the Old Bailey Hotel)

A complete decorating package for 111 guest rooms across seven storeys: paint, specialist wallcoverings and window film, delivered over about two years inside a Grade II-listed Victorian hotel opposite the Central Criminal Court.

Sample room at Hyde London City with a Timorous Beasties Tropical Clouded Leopard panel behind the bed.

Project record

Client, materials & project facts
Client
15 Old Bailey, opened 2 September 2024 as Hyde London City
Designer
Studio Moren (interior design)
Main contractor
Not recorded
Maker and paper
Timorous Beasties – Tropical Clouded Leopard, Vanilla; Timorous Beasties – Totem Damask, Black & Blue; House of Hackney – LIMERENCE, Galapagos; Solar Screen window film
Area or rooms
Not recorded
Scope
Full decorating package: decoration, specialist wallcoverings and window film
Year
2022–2024 (about two years on site; opened 2 September 2024)

As featured by Timorous Beasties: Studio Moren x Timorous Beasties at Hyde London City. Their story shows the two designs in the finished bedrooms.

At a glance

  • Building: 15 Old Bailey, City of London. Grade II listed, completed 1874
  • Opened: 2 September 2024 as Hyde London City
  • Duration: about two years on site (our photographs run from a sample room in November 2022 to final touches in August 2024)
  • Rooms: 111 guest rooms across seven storeys
  • Interior design: Studio Moren
  • Our package: full decoration, specialist wallcoverings and window film
  • Wallcoverings: Timorous Beasties Tropical Clouded Leopard and Totem Damask (custom-printed vinyl), and House of Hackney LIMERENCE
  • Window film: Solar Screen

The building

Old Bailey takes its name from the line of the City’s ancient wall, its “bailey”, just beyond which the street runs. For centuries the name has meant justice: the old sessions house stood beside Newgate Prison, and both were swept away for E. W. Mountford’s Central Criminal Court, opened by King Edward VII in 1907.

Number 15 is older than its famous neighbour. Completed in 1874 by Evans Cronk as the Spiers & Pond hotel, it is recorded as the first hotel in London to have electric lighting. It later spent decades as offices. In 2024, after a full restoration, it returned to its first purpose: on 2 September 2024 it opened as Hyde London City, an Ennismore hotel.

It is a building of carved stone bays, arched and round oculus windows, a sweeping timber-railed staircase and rooftop views of St Paul’s. Every one of those features had to be decorated around, protected and finished to a standard that suits both a listed building and a design-led hotel.

The design

The interiors were designed by Studio Moren. For the bedrooms they selected two Timorous Beasties designs, produced as custom-printed vinyl wallpaper: Totem Damask in Black & Blue, and Tropical Clouded Leopard in Vanilla. Vinyl lets the patterns stand up to the daily wear of a busy hotel while keeping their colour and detail. Timorous Beasties describe the result as “bold pattern with atmosphere” (Timorous Beasties).

The brief

One team, one standard, from the first sample room to handover: the complete decorating package for 111 guest rooms across seven storeys and the circulation spaces, the specialist wallcoverings that give each room its character, and the window film to the glazing.

Our approach

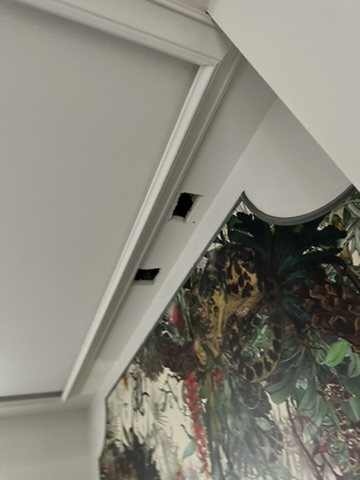

Sample room first. Our record starts in November 2022 with a finished sample room: Timorous Beasties’ Tropical Clouded Leopard set behind the bed as a shaped headboard panel. Agreeing the finish, the setting out and the detailing in one room first meant that the next 110 could be repeated with confidence.

Preparation. A building of this age moves and varies from room to room. New and old surfaces were filled, made good and primed so that the paint and wallcoverings sit on a sound, even base. Our photographs show walls taken back to a smooth finish before a single drop was hung.

Setting out large-scale pattern. Tropical Clouded Leopard is a large-scale, quarter-drop design. Hung as a shaped panel behind each bed, its placement has to be judged room by room so the composition sits centrally and reads as intended. Totem Damask runs differently: a single ten-metre repeat with no horizontal match, so every drop has to be chosen by eye to keep a feature wall balanced.

The suite. In the suite, House of Hackney’s LIMERENCE in the Galapagos colourway wraps the room in lush, painterly palms, including the bedroom and the dressing area. It is supplied as four 45 cm panels per roll, so the panels had to be hung in sequence and aligned precisely around joinery and windows.

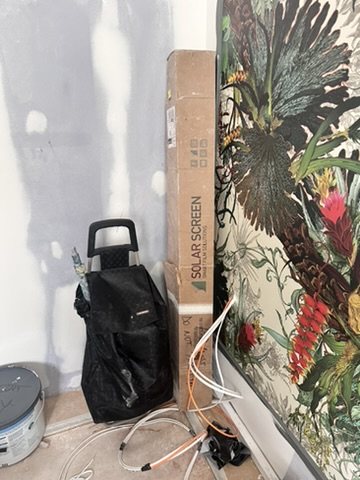

Window film. Alongside the decoration, we fitted Solar Screen window film to the glazing. See our window film service.

Decoration throughout. The decorating package ran through corridors, stair cores and rooms: deep greens and warm terracottas in the circulation spaces, crisp finishes to the panelling, and careful cutting-in around period mouldings, balustrades and the timber handrail of the main stair.

Materials

  • Timorous Beasties – Tropical Clouded Leopard, Vanilla, custom-printed vinyl: guest-room headboard walls
  • Timorous Beasties – Totem Damask, Black & Blue, custom-printed vinyl: guest-room feature walls
  • House of Hackney – LIMERENCE, Galapagos: the suite
  • Solar Screen window film: glazing

Outcome

On 2 September 2024 the first hotel in London to be lit by electricity reopened as a hotel, 150 years after it was built. Guests walk into bedrooms dressed in Timorous Beasties’ leopards and kaleidoscopic damasks, a suite wrapped in House of Hackney palms, and corridors and stairs finished to match, all of it delivered by our team.

Notes and sources

  1. 111 guest rooms across seven storeys, Grade II-listed Spiers & Pond building of 1874, opened 2 September 2024, Studio Moren: Ennismore, “Hyde London City has officially opened its doors”, 2 September 2024: https://ennismore.com/stories/hyde-london-city-has-officially-opened-its-doors/ and the Ennismore press release: https://ennismore.com/wp-content/uploads/sites/9/2024/09/Hyde-London-City-Hotel-Now-Open.pdf

How the commission ran

The same standards, on every commission.

Each commission has a written scope by room, walls prepared until they are true, protected floors, batch and shade control, set-out from the room’s focal points, and a return visit. Read the method.

The six standards in full
  1. 01

    Survey and scope, room by room

    We measure the wall that will actually be hung, allow for the repeat and the wastage, and write a scope of works room by room before anyone orders paper.

  2. 02

    Preparation decides the finish

    Walls are filled, made good and primed until they are true. If a wall is not ready for the material specified, we say so before the last drop is ordered.

  3. 03

    Protection and containment

    Floors, furniture and finished joinery are protected as part of the hang. Work is contained and the place is left tidy each evening. In a home we are visitors; in a hotel we work around the house.

  4. 04

    Batch and shade control

    Deliveries are checked against the measure, and batches and shading are managed so that a corridor of rooms reads as one surface.

  5. 05

    Set out from the room's focal points

    Pattern is set out from chimneypieces, doorcases and bed walls, so the pattern sits square to the cornice and the joinery.

  6. 06

    One team, then the return visit

    The people who start are the people who finish. Four to six weeks after completion we come back to look at every seam and edge, and the workmanship is guaranteed for twelve months.

See the finish up close: seams, internal corners, edges and joins from our own installations

By Dorin Burcus, founder · Last updated
